Western Downs Solar Farm – Battery Storage Facility (Stage 2)
Universal Cranes worked with UGL Engineering to unload and place 140 Tesla Megapack battery units, 140 transformers and two switch rooms at Kogan Creek, with incident-free lifting throughout.
UGL Engineering Pty Ltd
Site owner: Neoen
Western Downs Battery Storage Project Stage 2
April – August 2025
Demag AC350/6 (350t All Terrain Crane)
Liebherr LTM1150-5.3 (150t All Terrain Crane)
60t All Terrain Crane
40t Franna
25t Franna
SCOPE
- Unload 140 x 38t Tesla Megapack battery storage units
- Unload and position 140 x 14t transformer units
- Unload and place 2 x 31t switch rooms
- Lift planning and engineering
- Pick, slew and place operations

OVERVIEW
Universal Cranes worked closely with UGL Engineering on the planning and execution of the Western Downs Battery Storage project at Kogan Creek, around a four-hour drive from Brisbane. The project was Stage 2 of the Western Downs Solar Farm battery storage facility.
Planning commenced in November 2024, and the formal contract for the supply of cranage was signed in April 2025.
LIFT PLANNING
The Universal Cranes lift engineering team worked closely with UGL to develop lift plans with crane locations to suit the nominated deliveries each day, so transport deliveries were not delayed. This included finding a single setup location where the main heavy lift crane could unload both the batteries and the transformers.
Crawler cranes were considered, but an All Terrain crane provided the best ground bearing pressure and radius options.

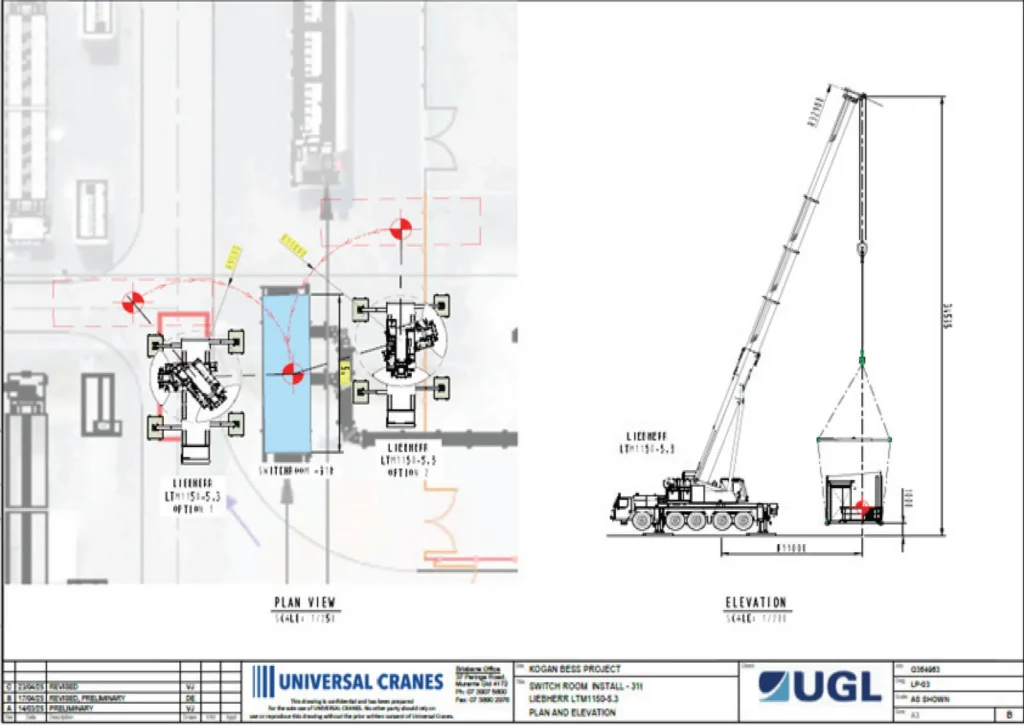

Planning also included a review of the switch room position and options to avoid underground cabling. 100t, 130t and 150t options were assessed, and the switch rooms were ultimately placed with the 150t All Terrain crane.


KEY EQUIPMENT USED

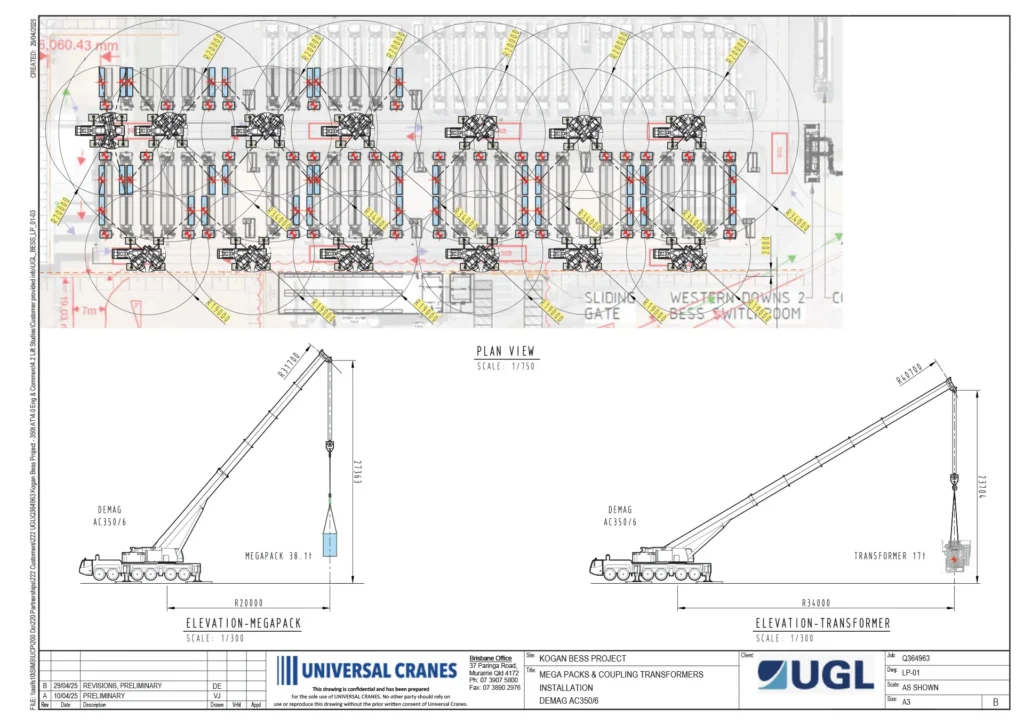

- Demag AC350/6 (350t All Terrain): main heavy lift crane for batteries and transformers from a single setup location
- Liebherr LTM1150-5.3 (150t All Terrain): switch room placement
- 60t All Terrain: multiple visits for site lifts
- 40t Franna: transformers while the 350t was lifting batteries
- 25t Franna: dry hired to assist with crane relocations and site lifts
ACHIEVEMENTS
- Incident-free lifting
- No injuries
- No equipment breakdowns
- Fatigue managed in a remote location

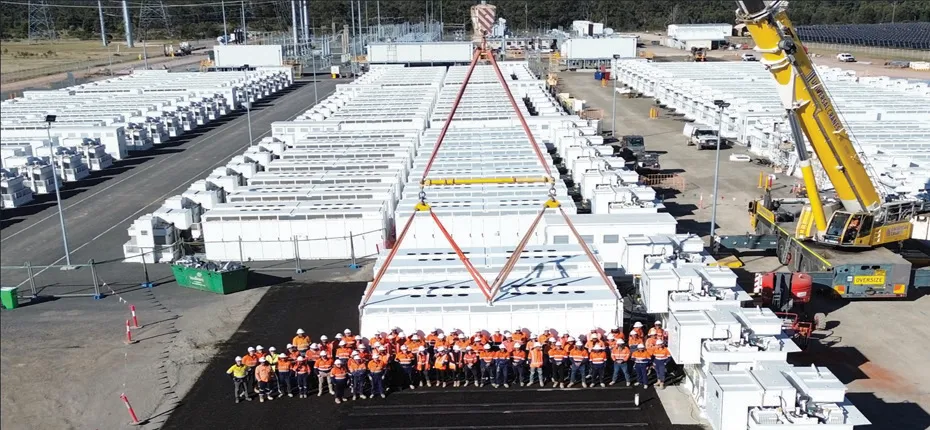

- Helped UGL celebrate the unloading and placement of its 1,000th battery on Australian projects
